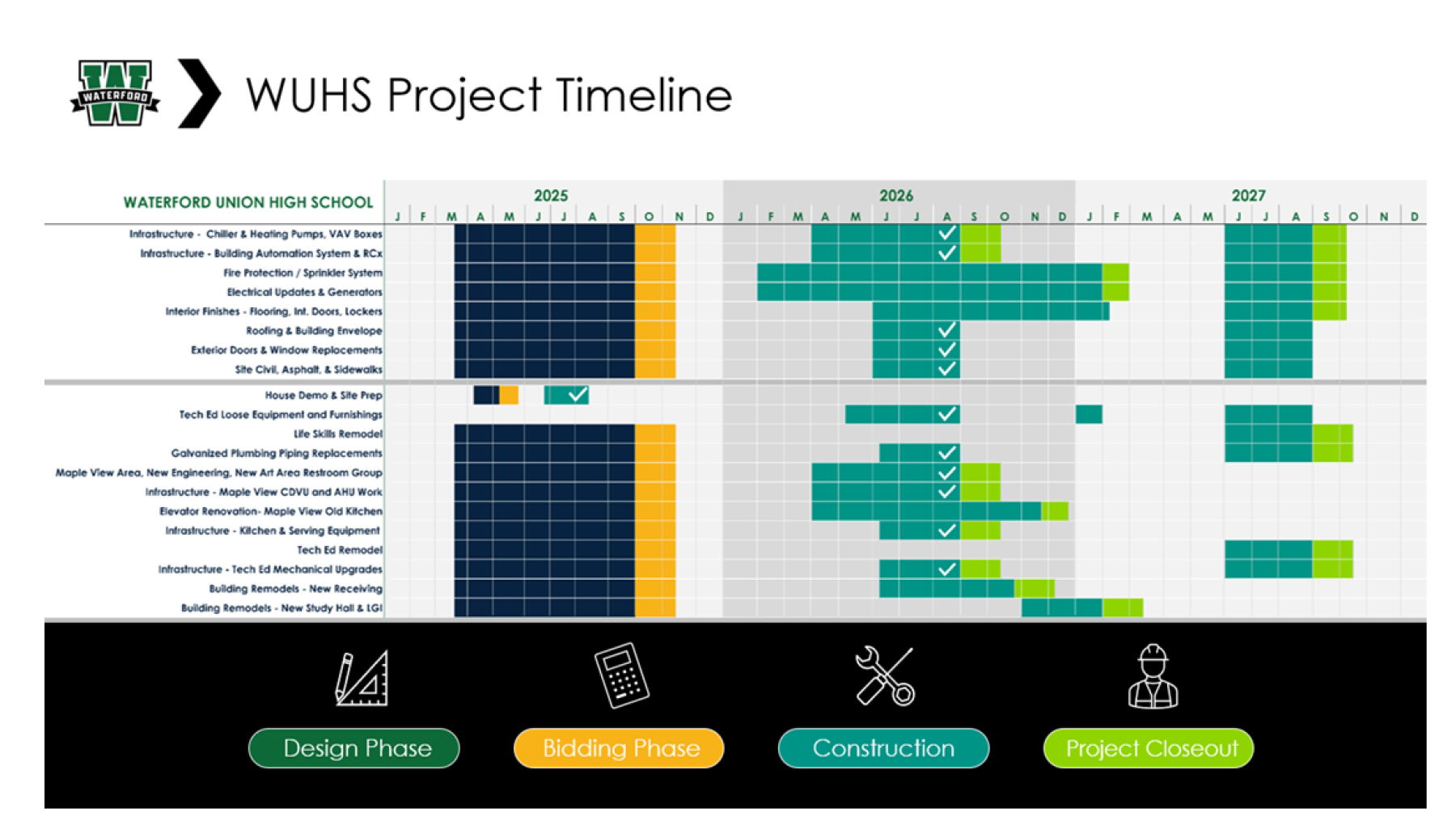

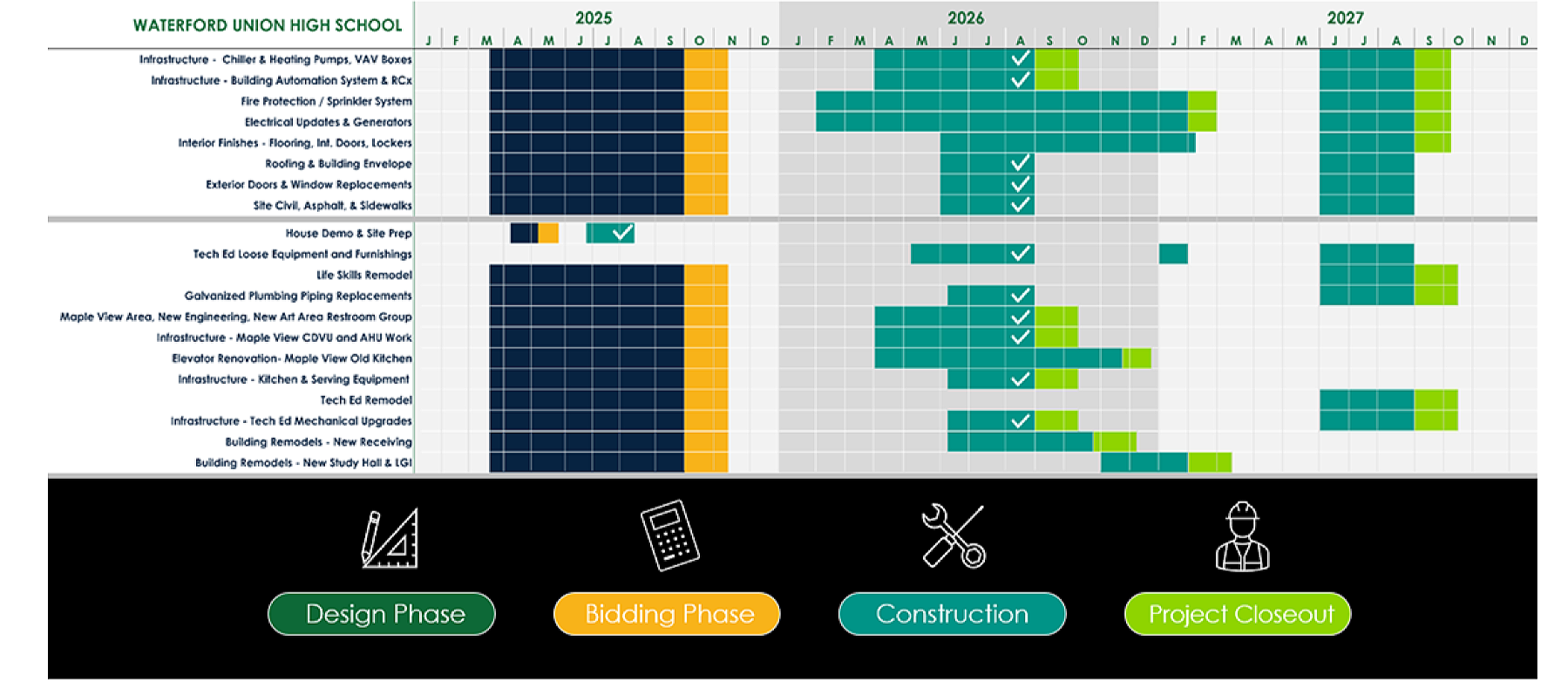

WUHS Project Timeline

September 2026 Update: Progress to Date

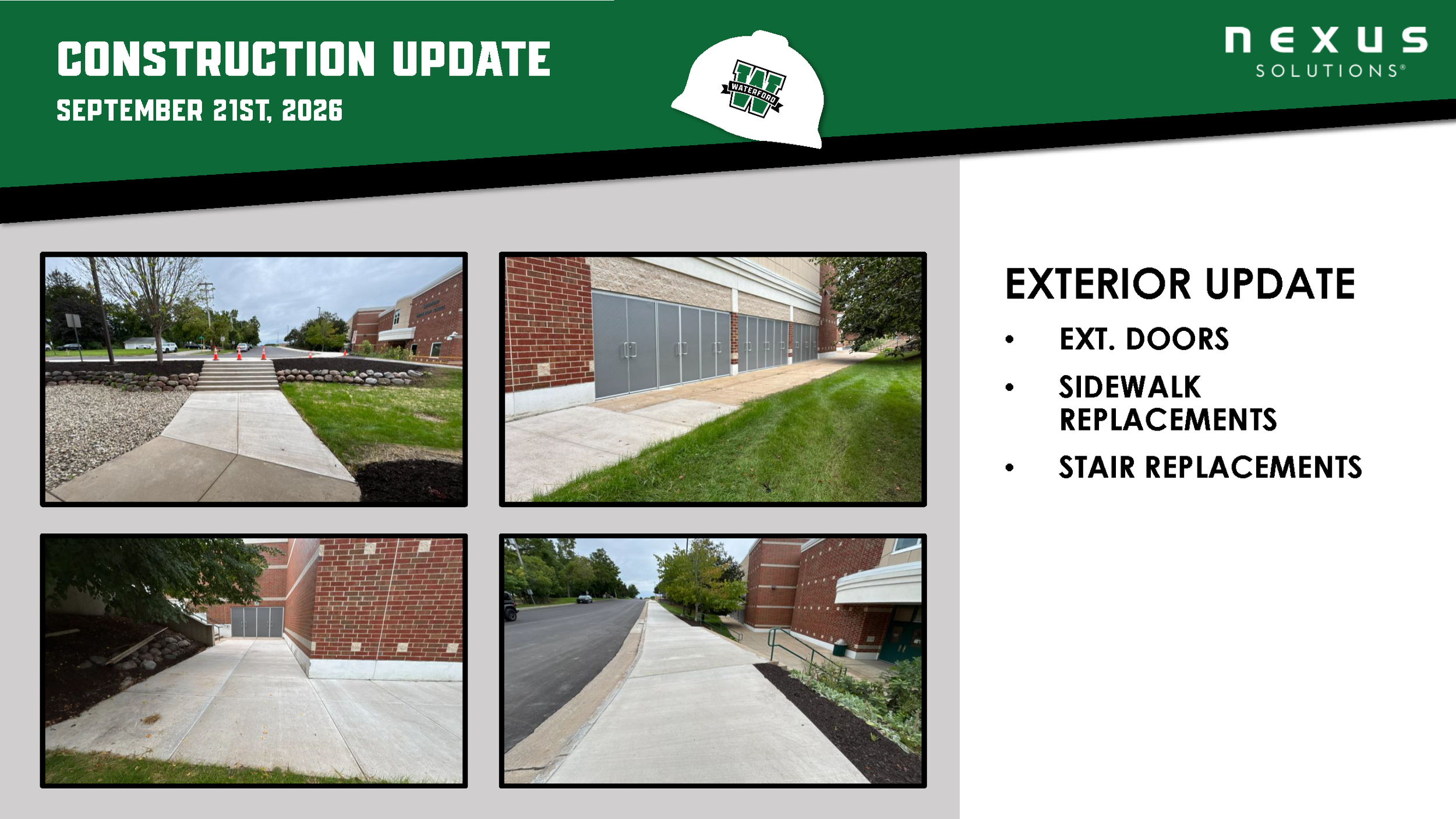

EXTERIOR UPDATES

  • Watermain installed for Fire Suppression System installation

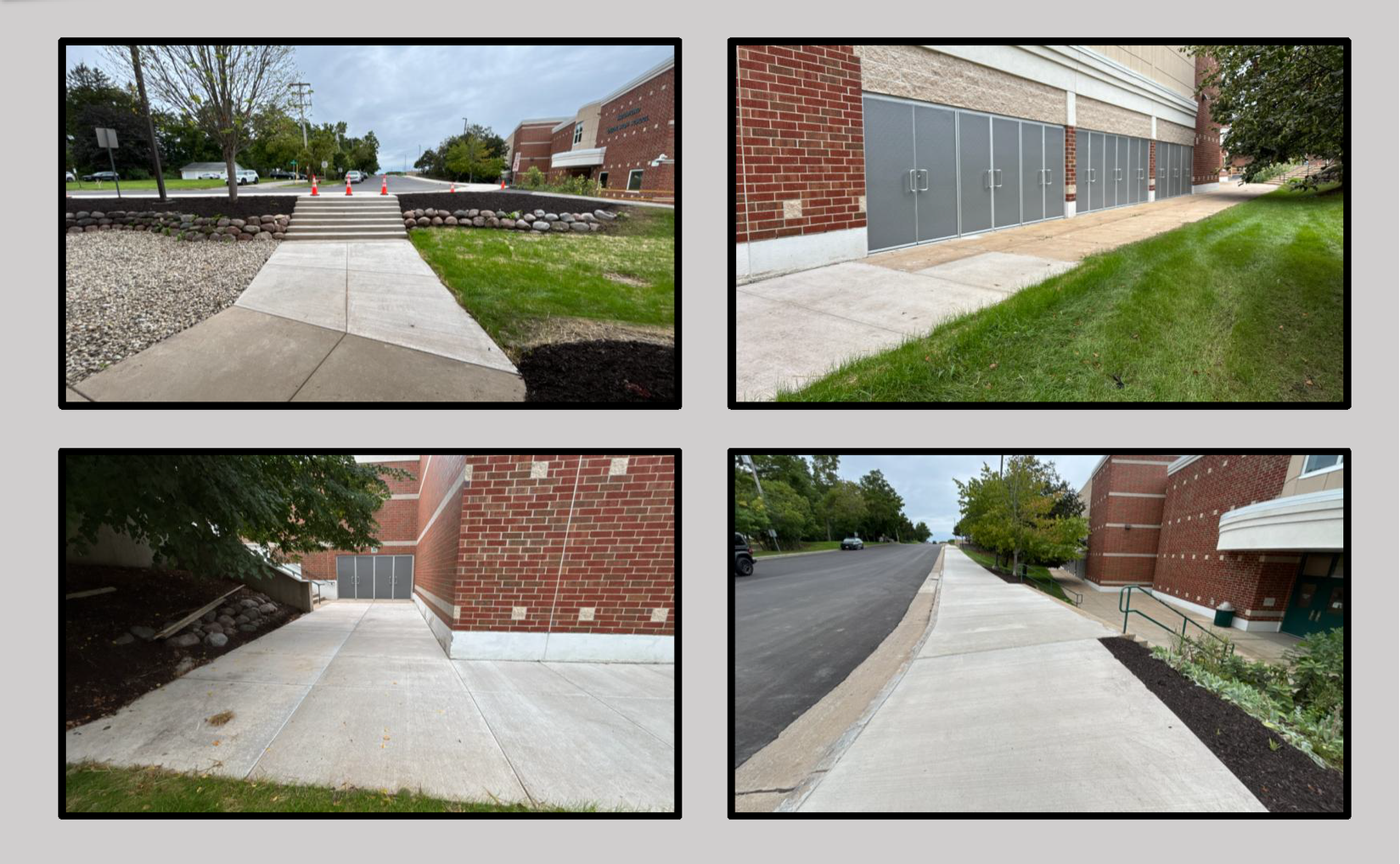

  • Concrete replacements along Field Dr. and Barnes Dr.

  • Concrete replacement outside of main and wrestling gym doors

  • Exterior door replacements in gym, cafeteria, tech ed area and district office area.

  • Window replacements in district office and student services.

  • Storm drain installation and regrading by Field Dr. and S. Water Street

  • Parking lot improvements and Housekeeping pads in south lot

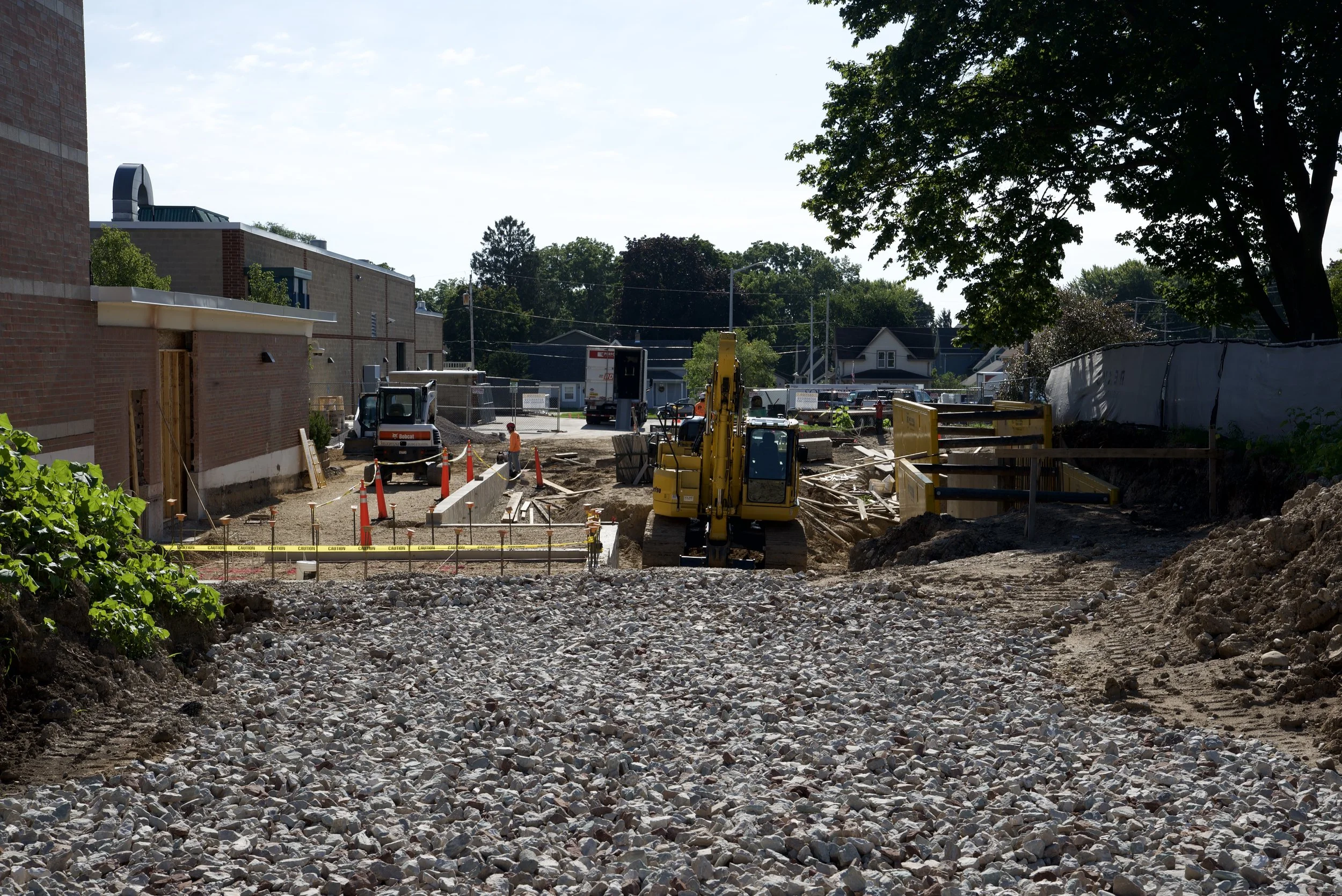

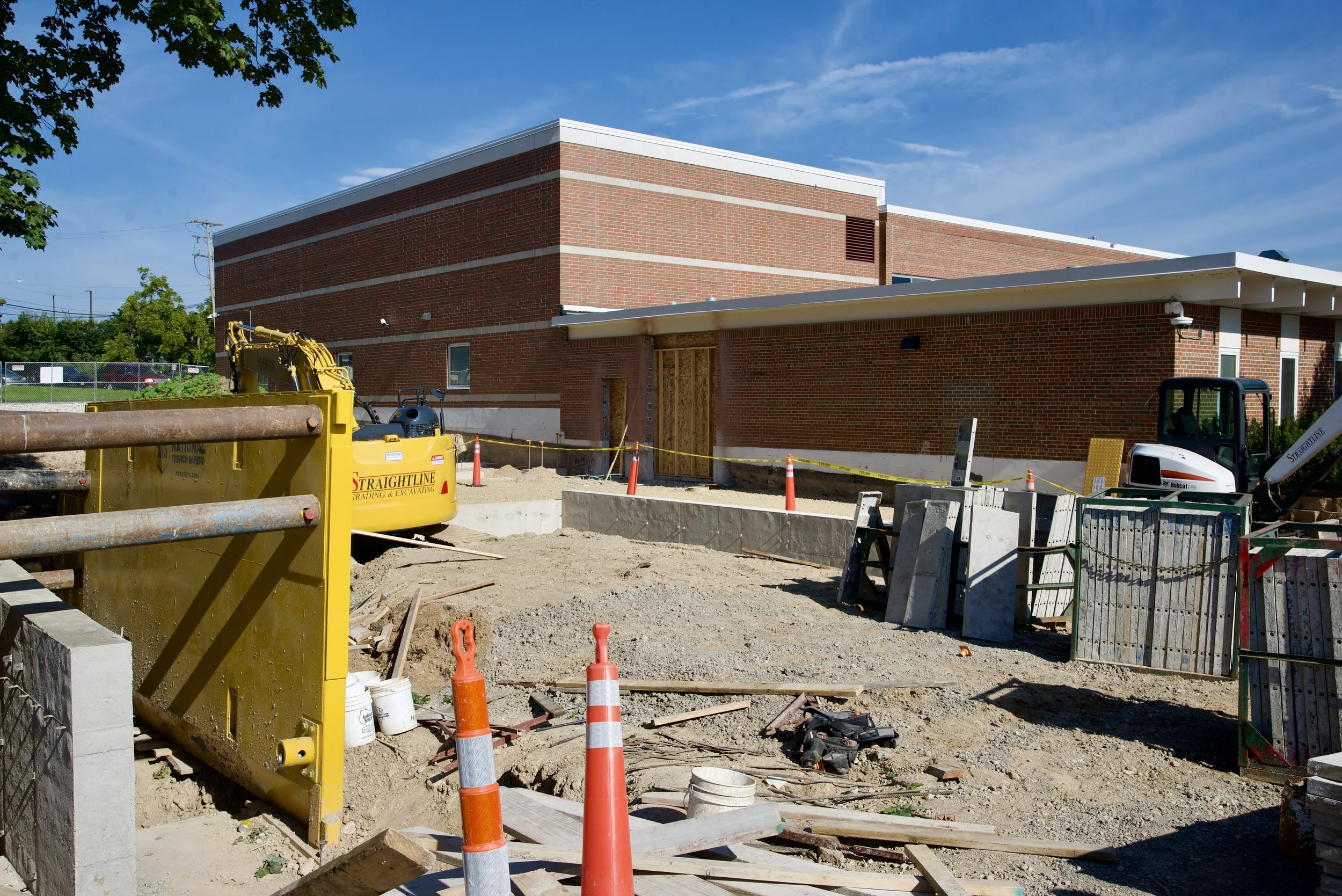

  • Loading Dock Construction underway completed mid-October

  • Roofing Replacements underway

INTERIOR UPDATES

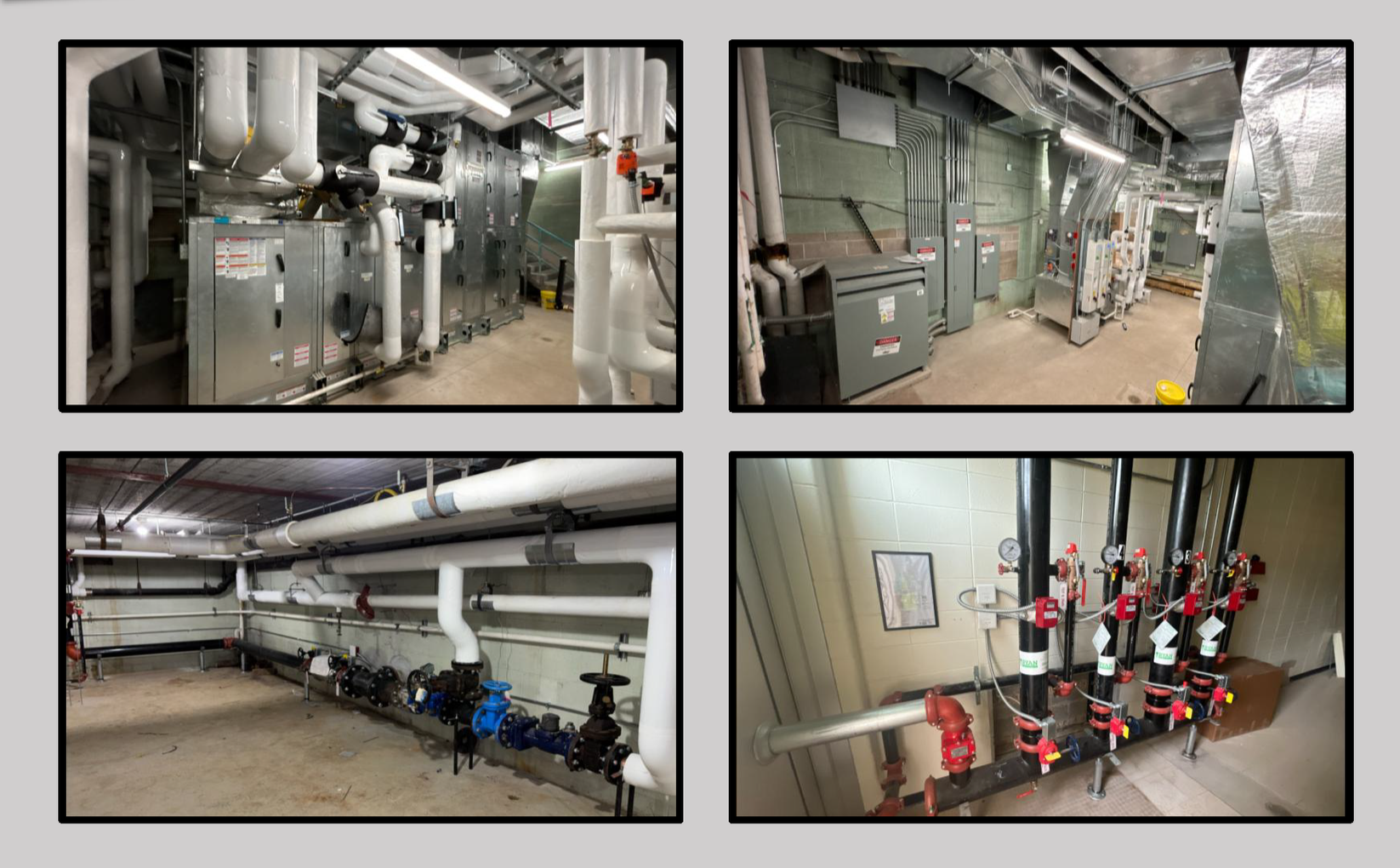

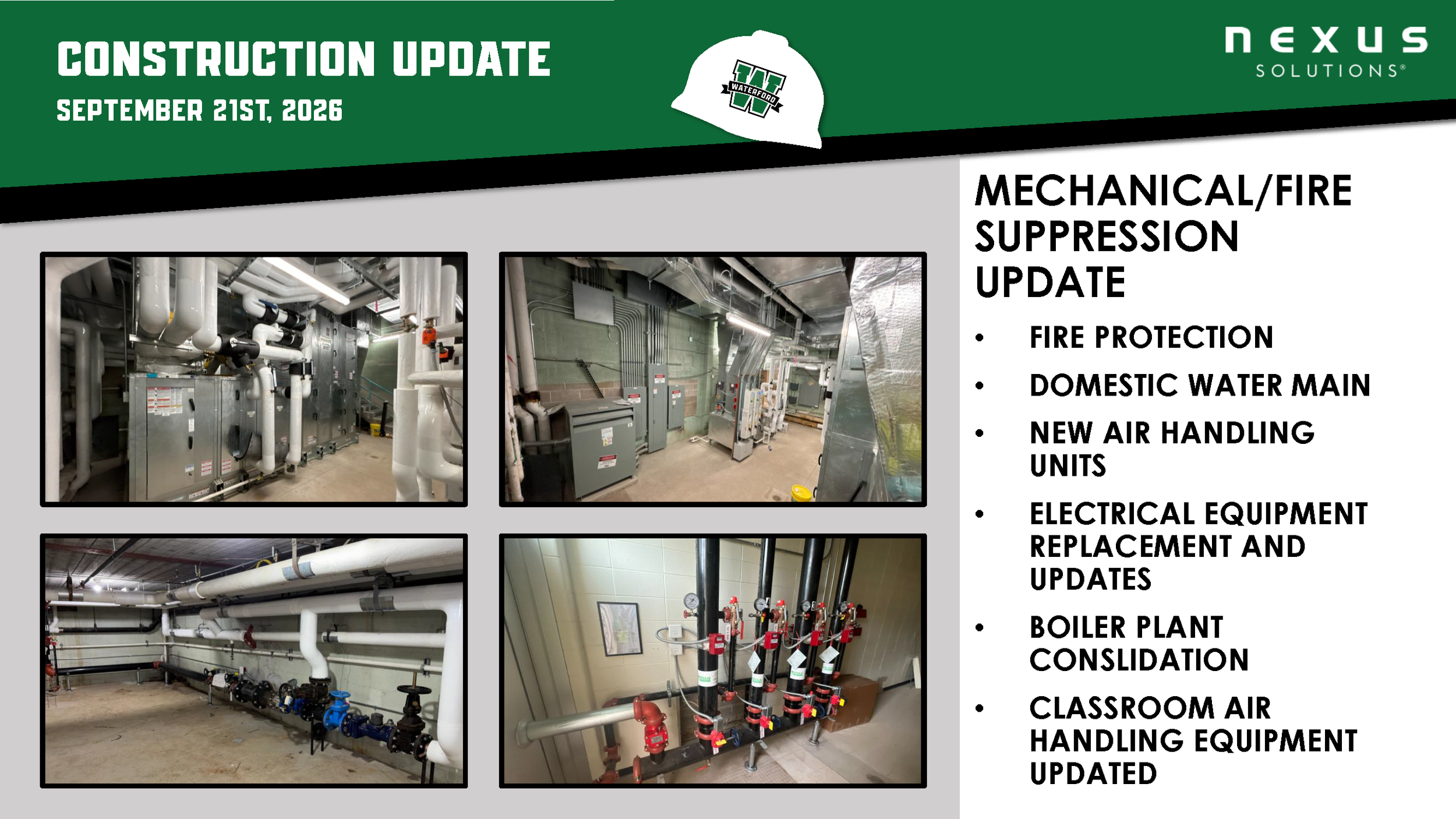

mechanical system updates

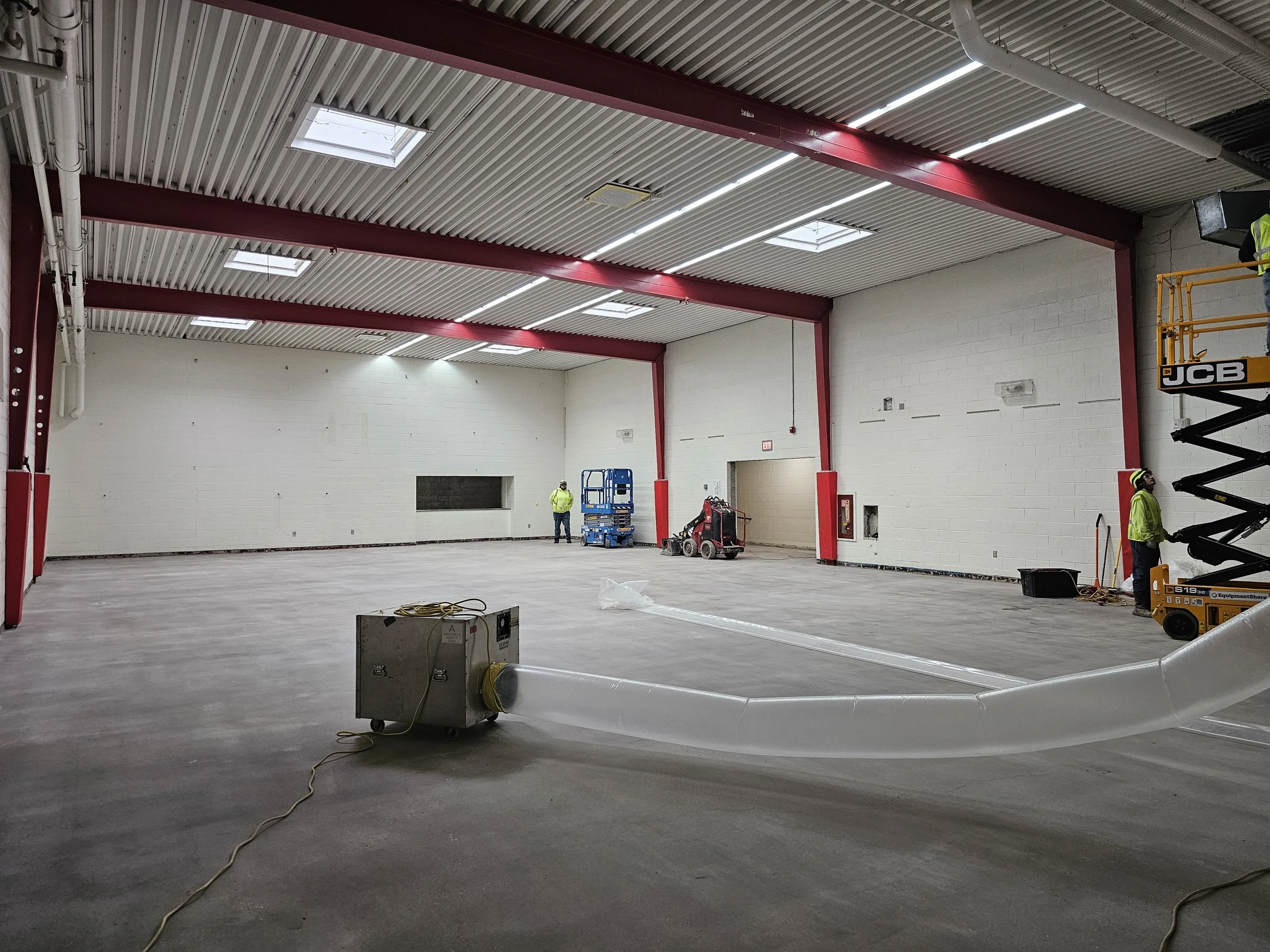

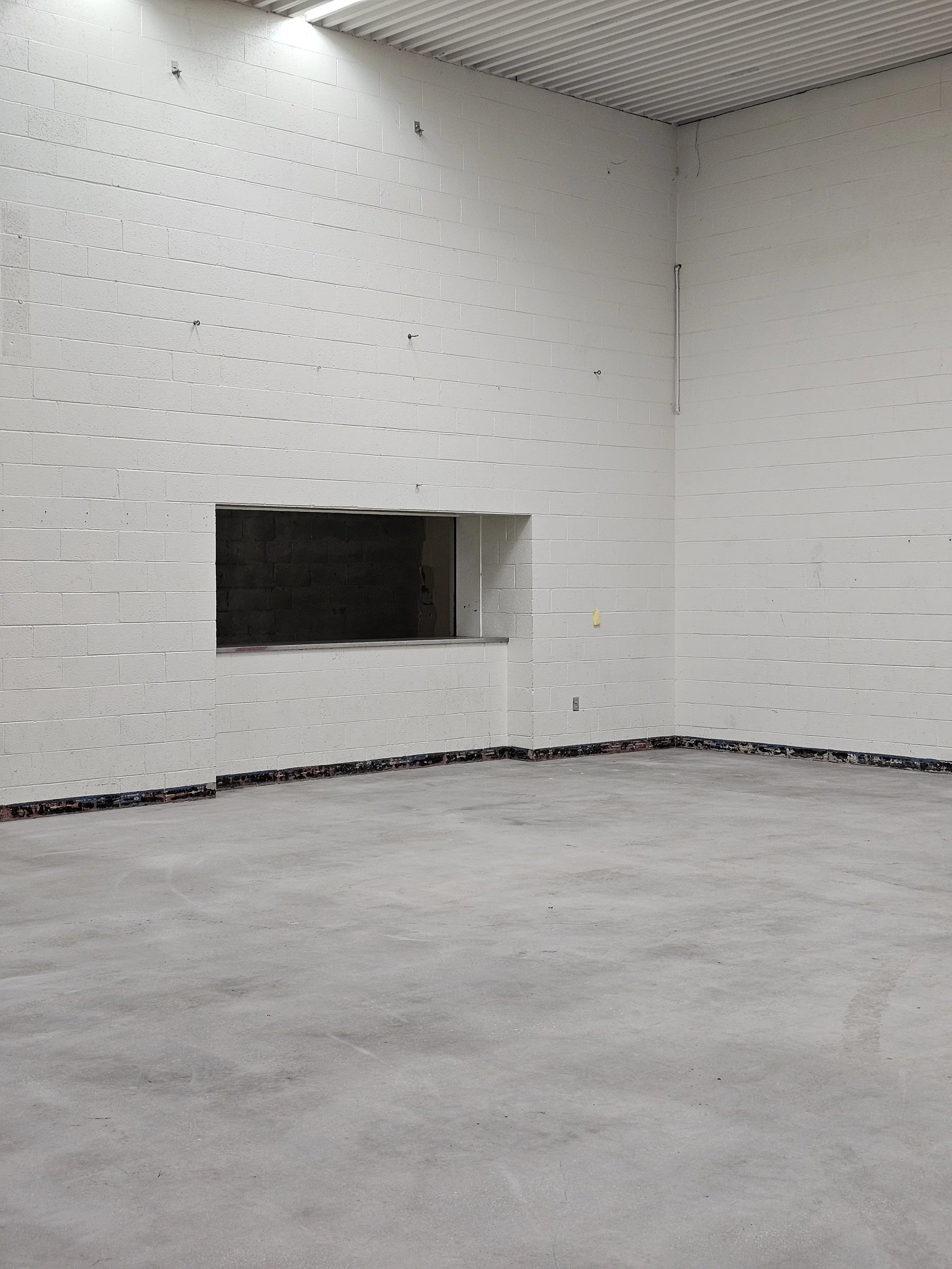

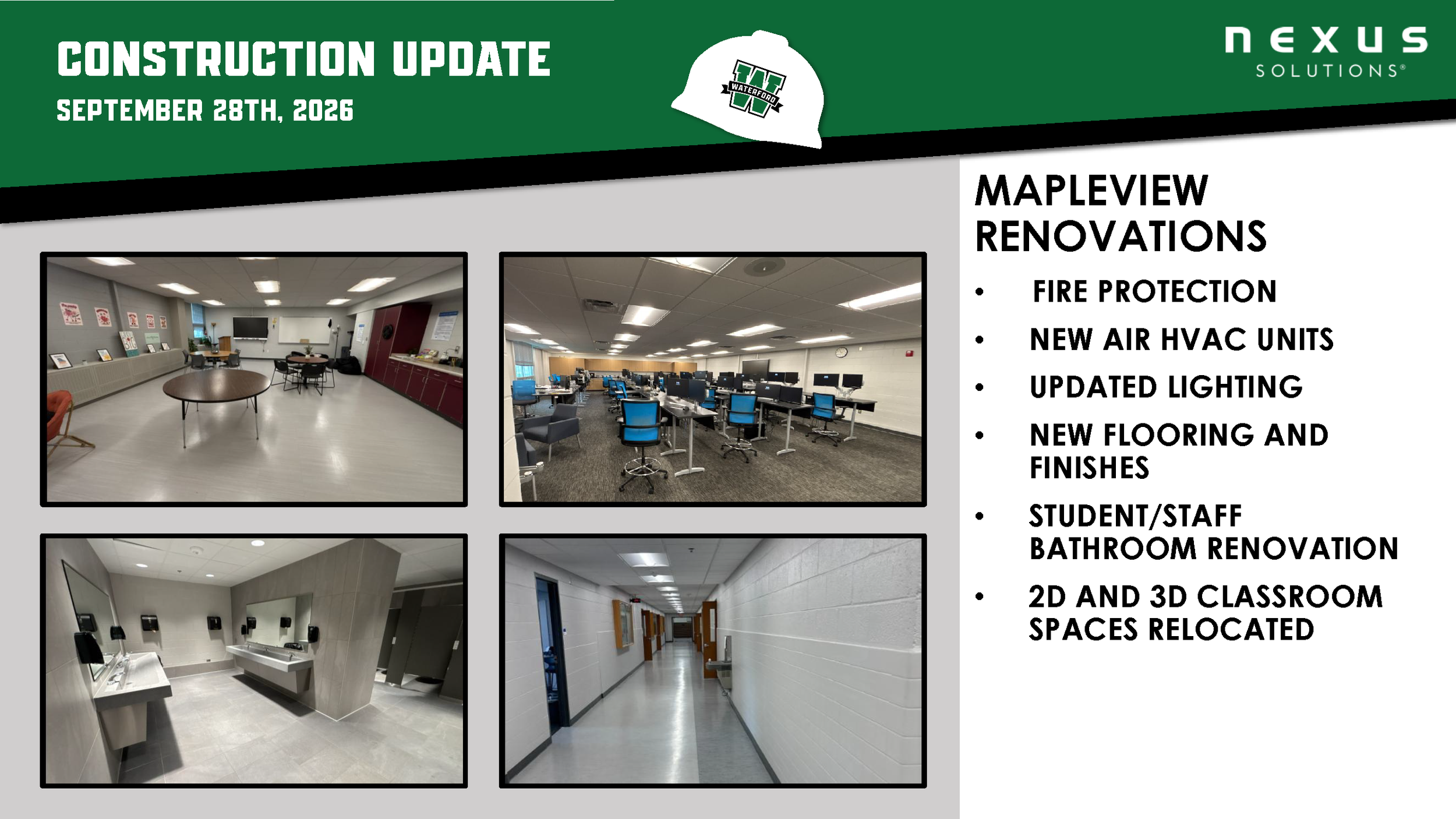

  • Maple view Renovations and Mechanical updates completed

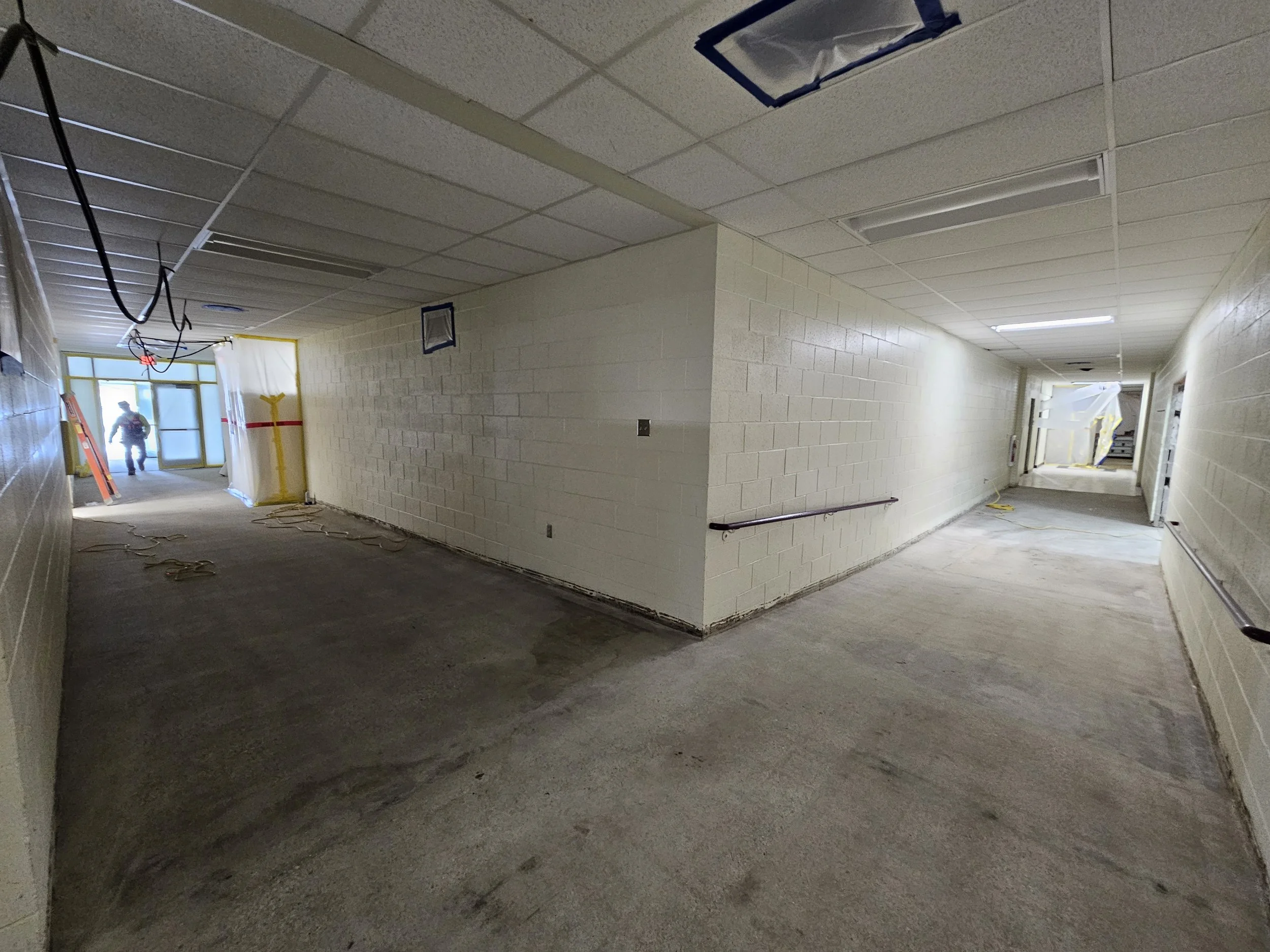

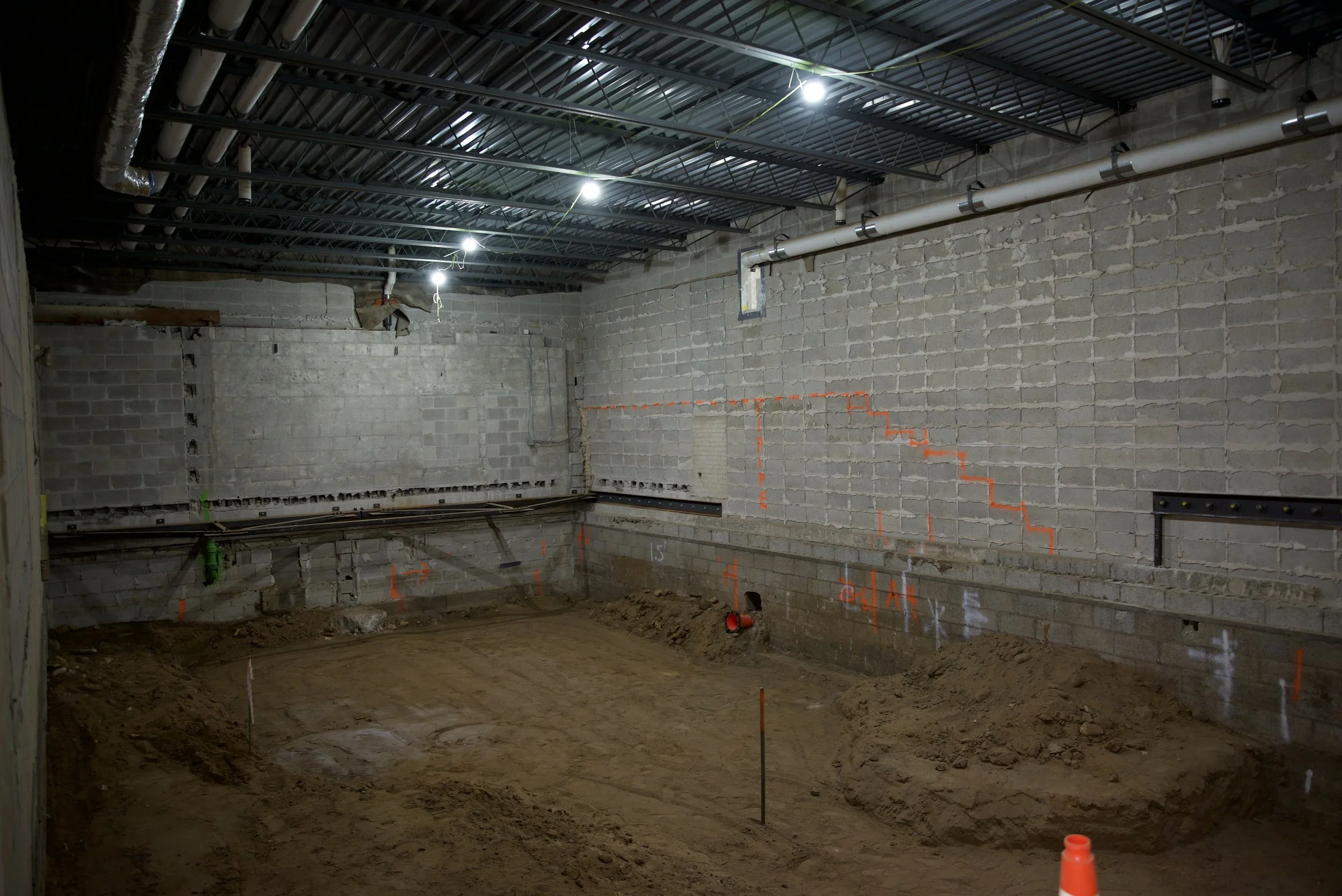

  • Elevator lobby into Maple view area under construction

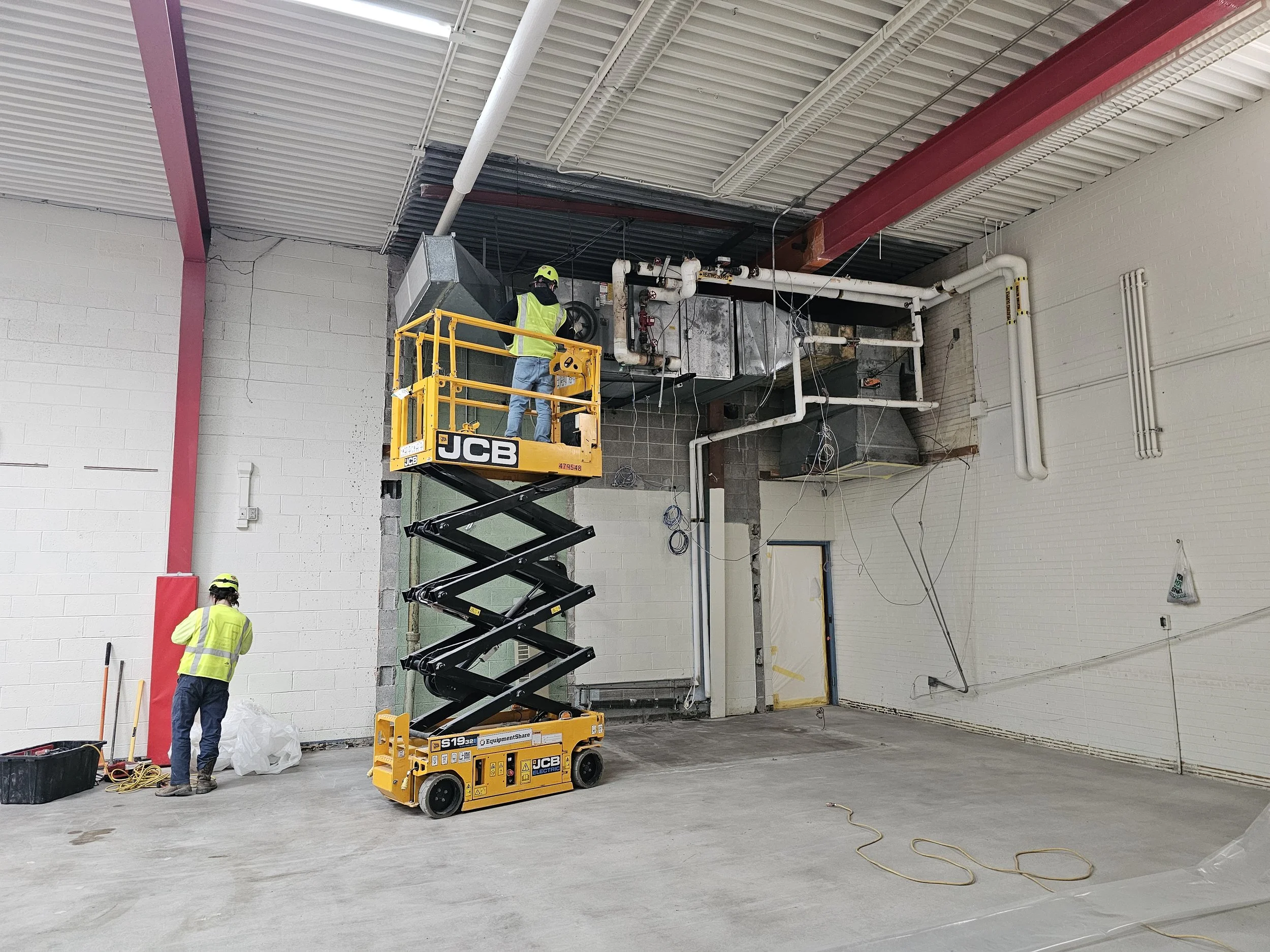

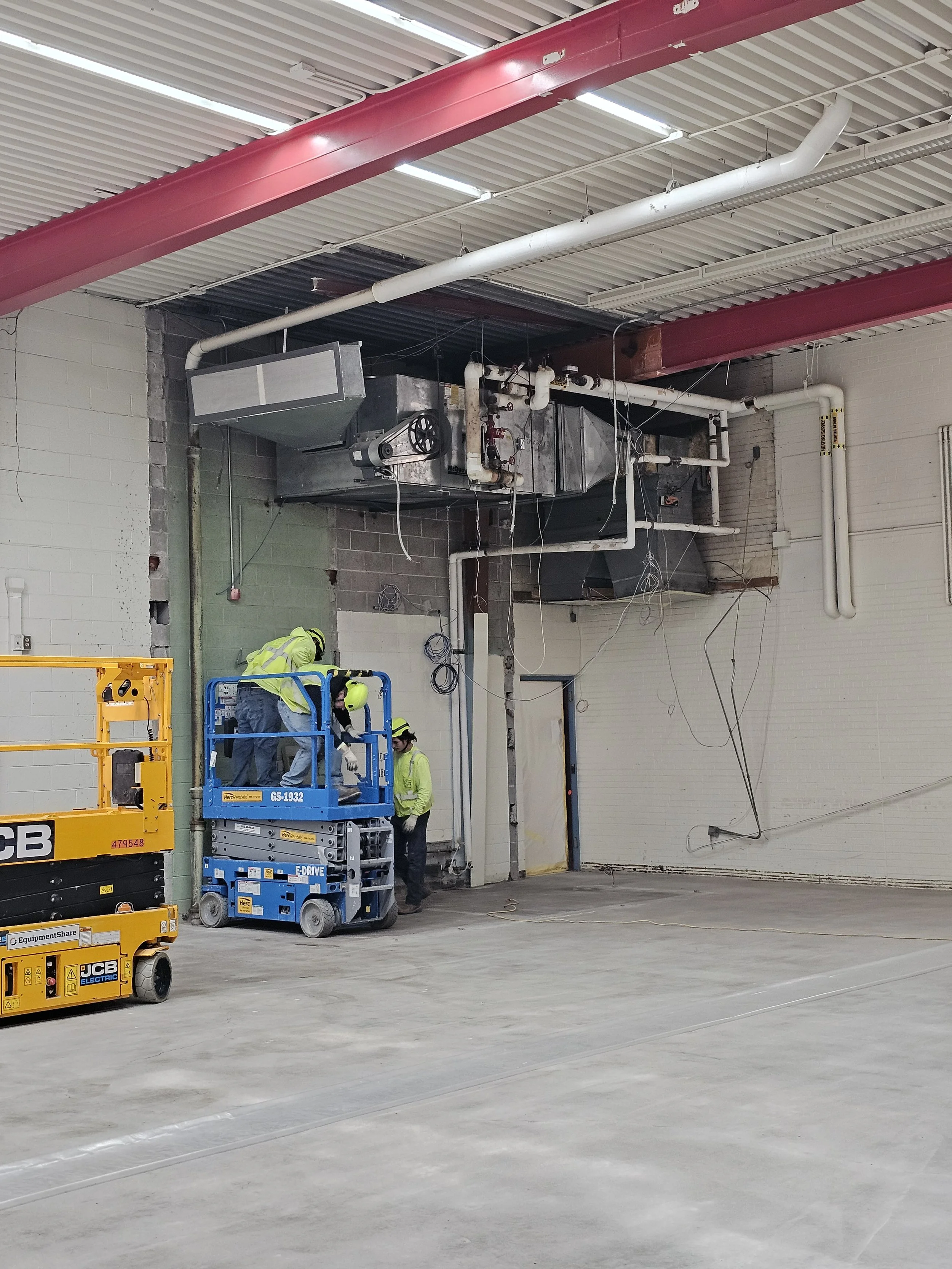

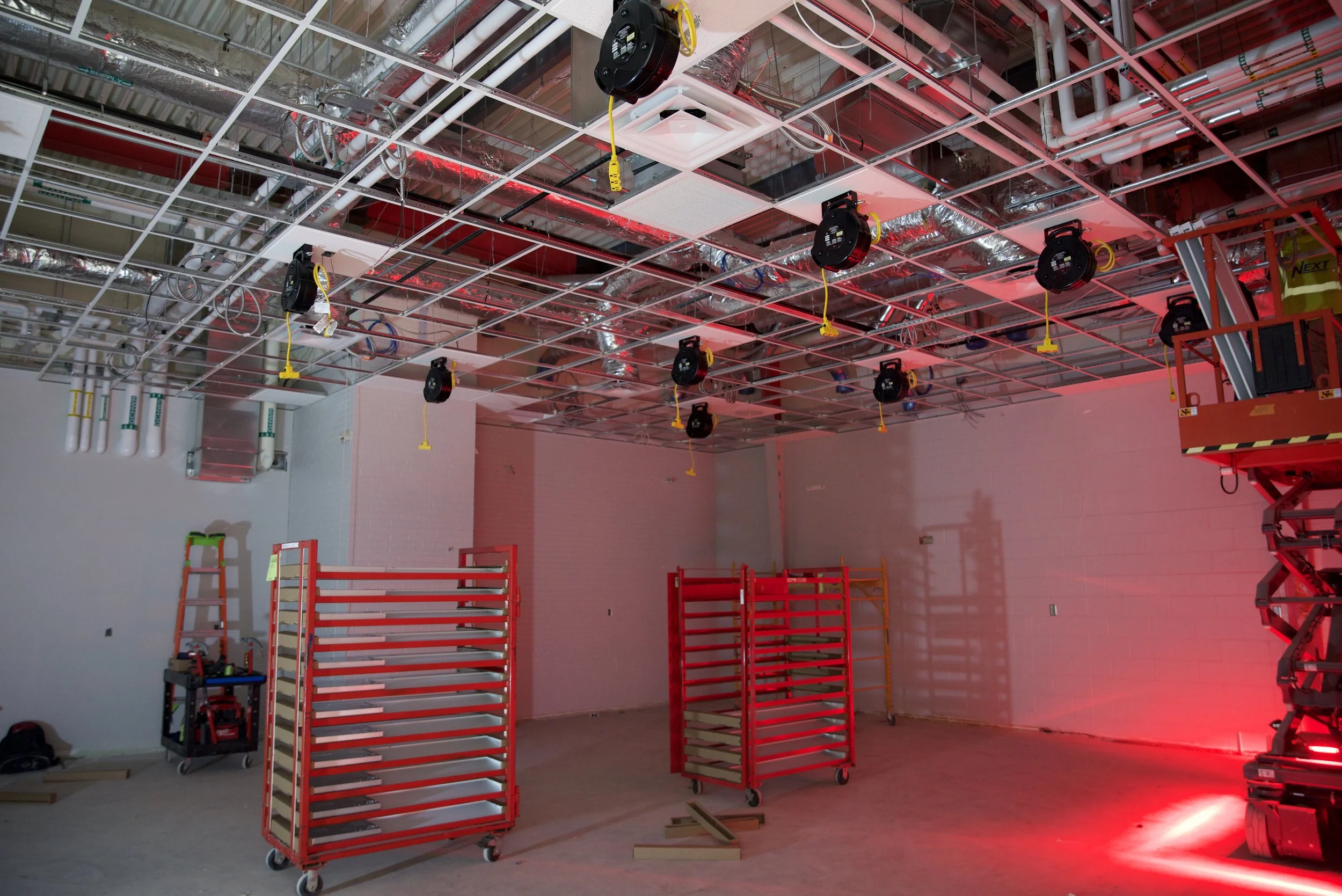

  • New mechanical air handlers and classroom units have been installed and are operational.

  • Heating hot water plant consolidation completed reducing maintenance from 3 plants to 2 plants.

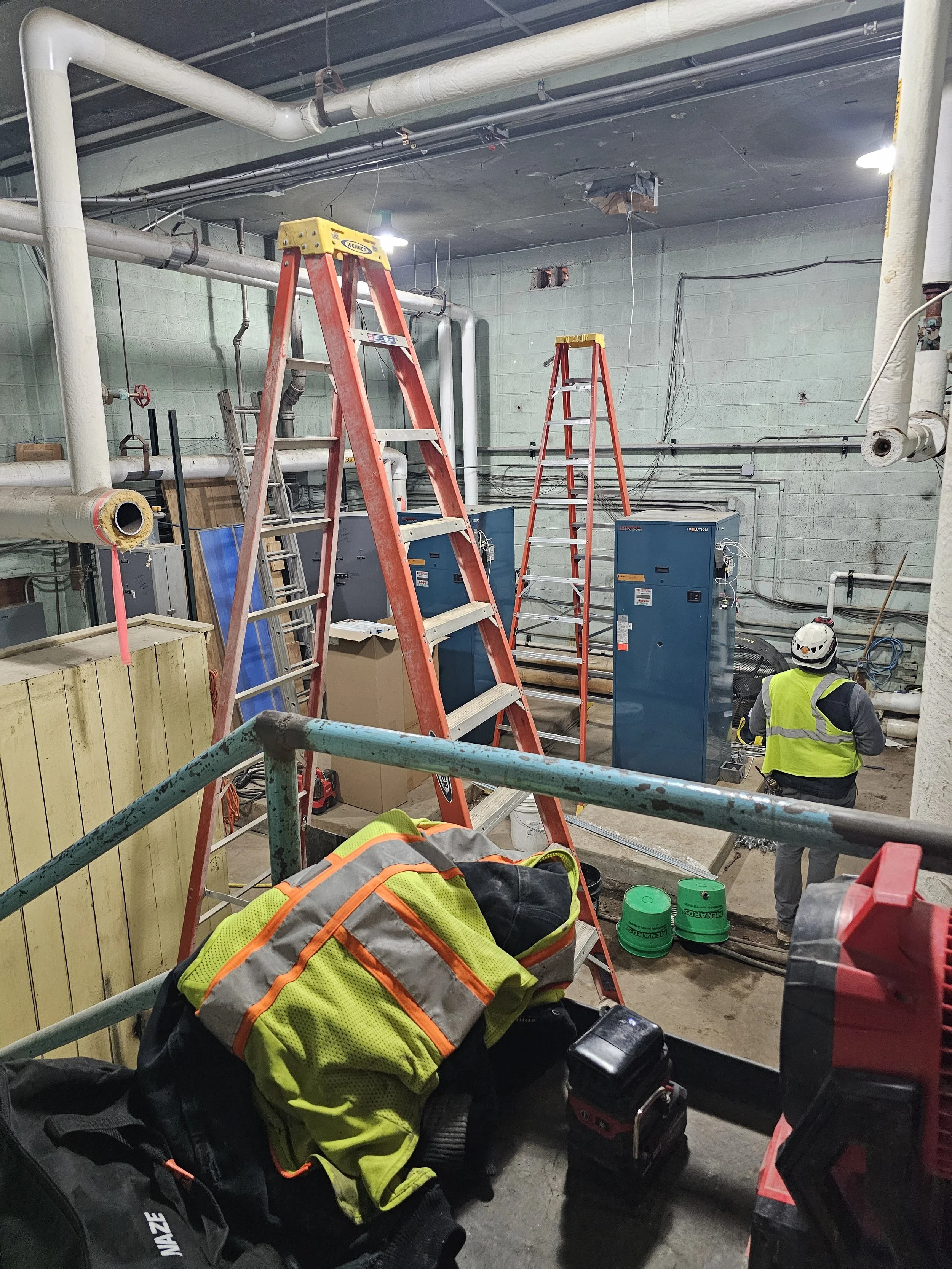

  • Fire alarm updates completed in Maple view renovation area and continuing through building

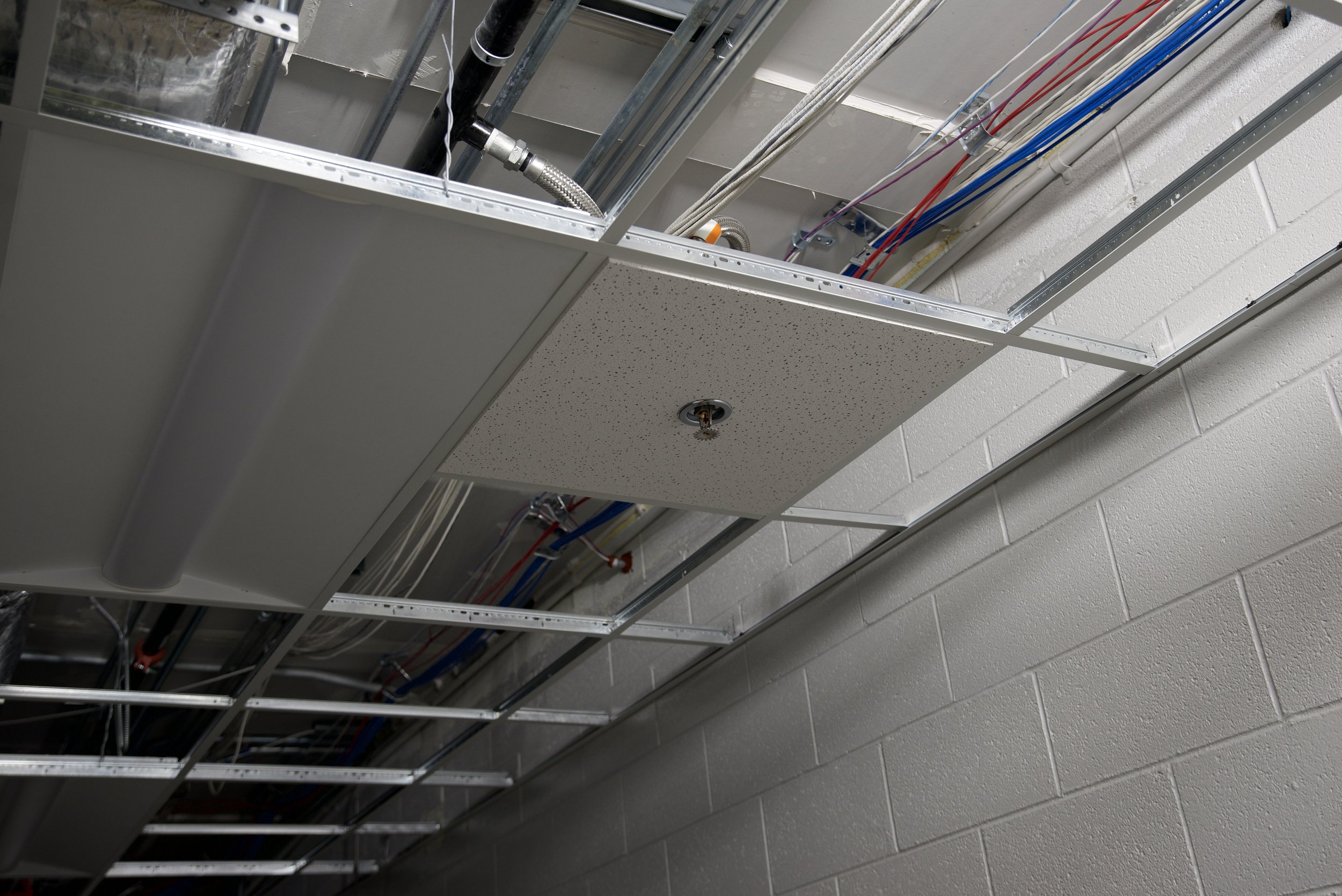

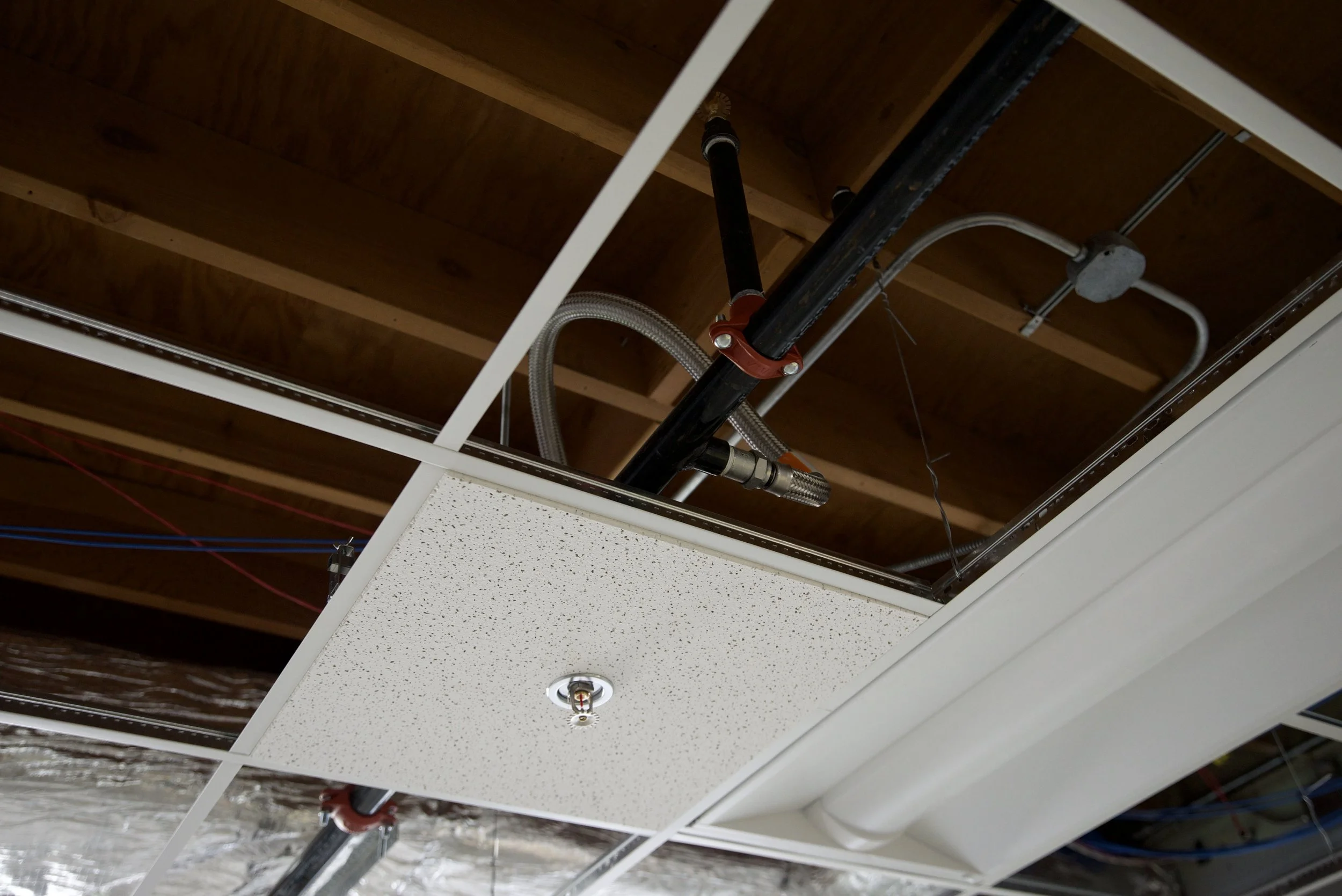

  • Fire protection system installation started through in building

  • Currently covered: Maple view area, Tech Ed Area, PAEC and back of house, Commons, Cafeteria, Center Street Gym and Small Gym

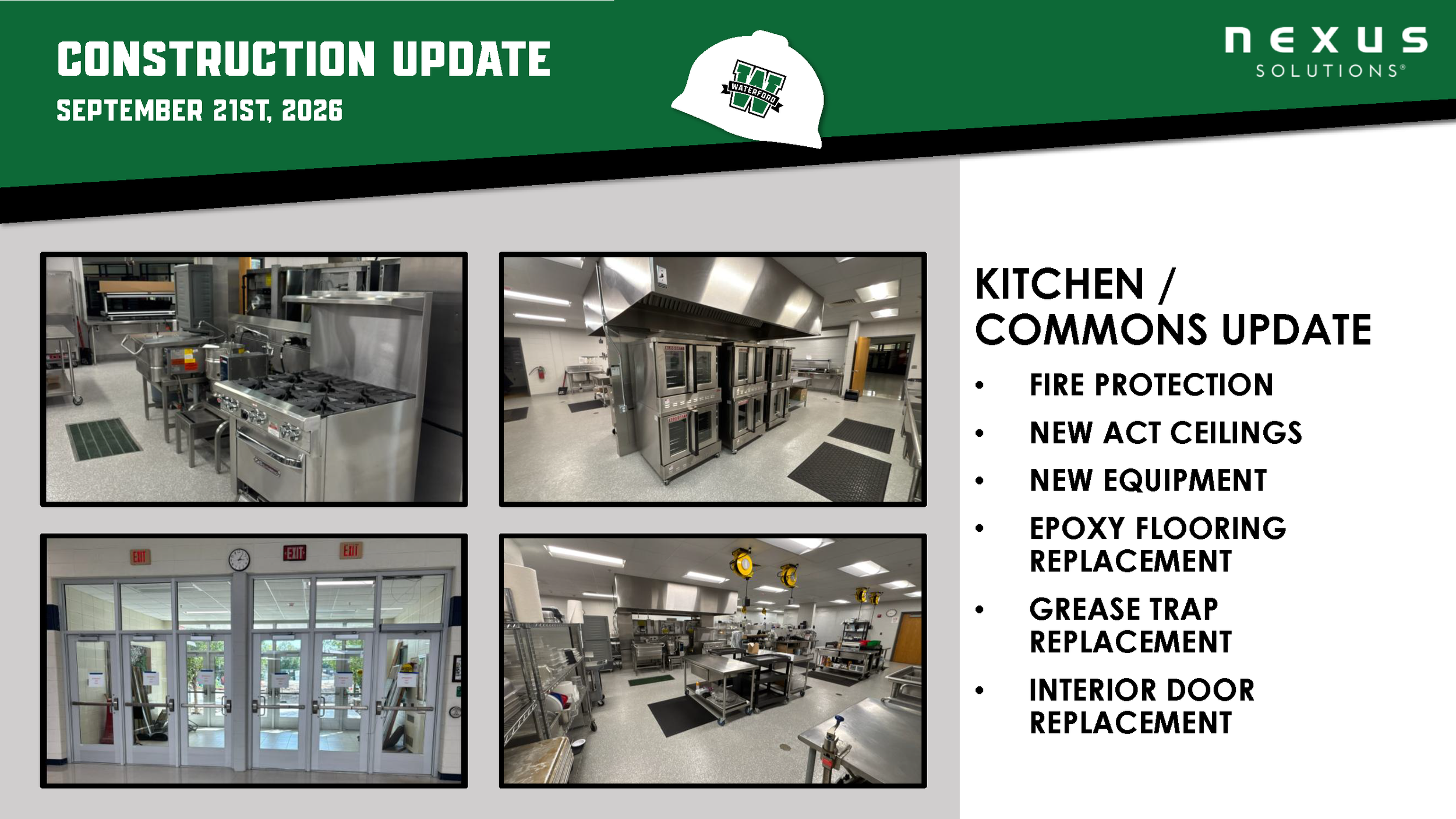

  • Food Service/Kitchen updates and new equipment including grease trap replacement and walk in updates

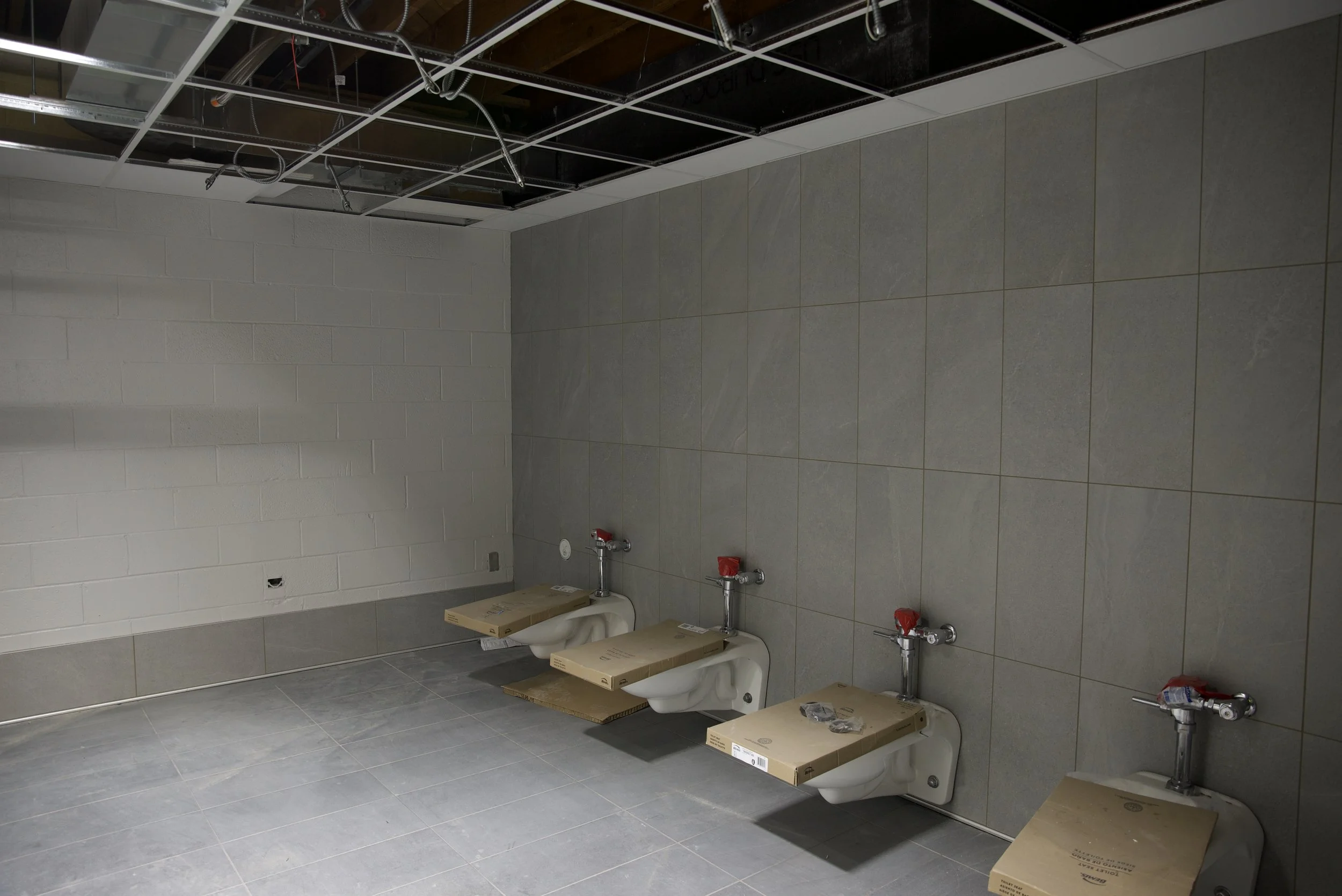

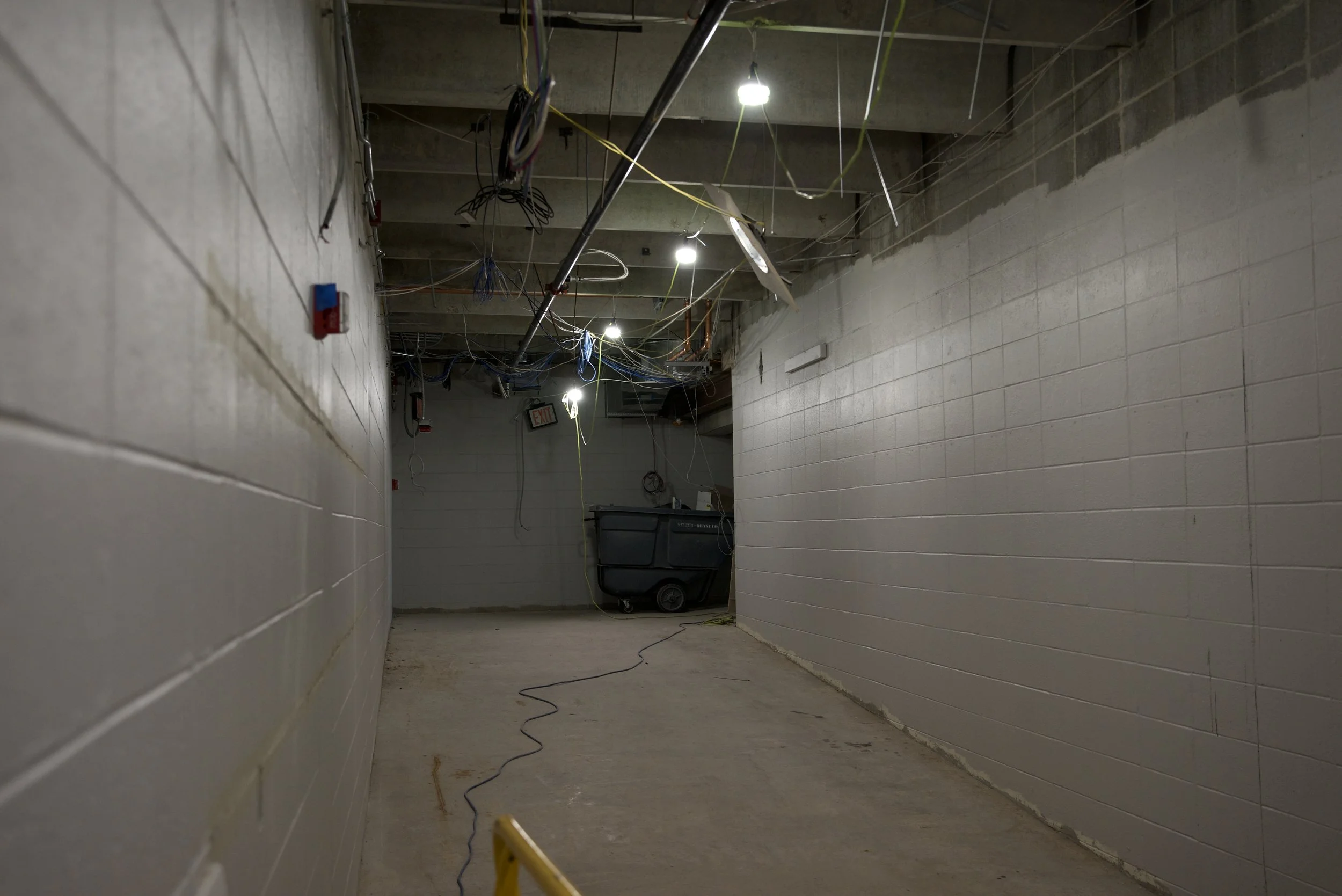

  • Access ramp by old 2d/3d art rooms installed and non functioning chair lift removed.

  • Existing flooring abatement complete in building.

  • New flooring replacements in classrooms started and continuing throughout the year.

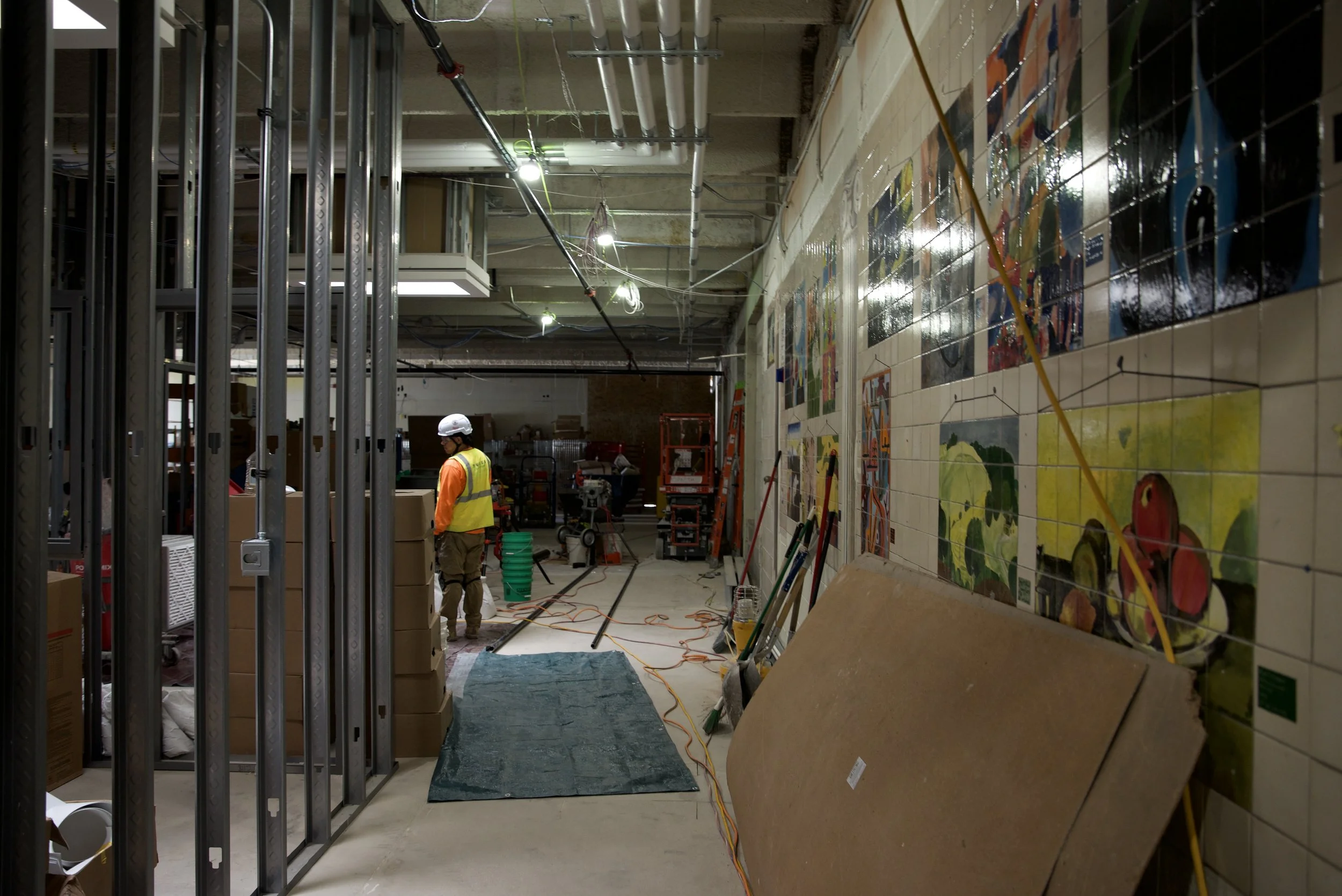

  • Receiving room renovations and re-work underway planned for completion Late October.

  • Suspended ceiling removal and replacements completed in commons, cafeteria and kitchen areas.

September 2026 Update: Additional Projects Added to Scope

β€’ Painting of all classrooms and corridors in Area D during renovation

β€’ Resizing D125 and D126 in to standard classroom sizes increasing usage abilities.

β€’ Full Building fire suppression. Original project covered only corridors west of cafeteria.

β€’ Updating of power and network cabling in area D during Renovation

β€’ Replacement of Area D corridor light fixtures during renovation

β€’ Adding of 1” compressed air line to art room to remove need for air compressor in that space

β€’ Adding windows to classrooms B132, B219, B220, B221 increasing natural light into classrooms

β€’ Additional exterior concrete replacements outside of gym area

β€’ Replacement of chair lift at back stage area

β€’ Door modifications between 2d and 3d art room

β€’ Some additional furniture in classroom spaces that were not originally planned for.

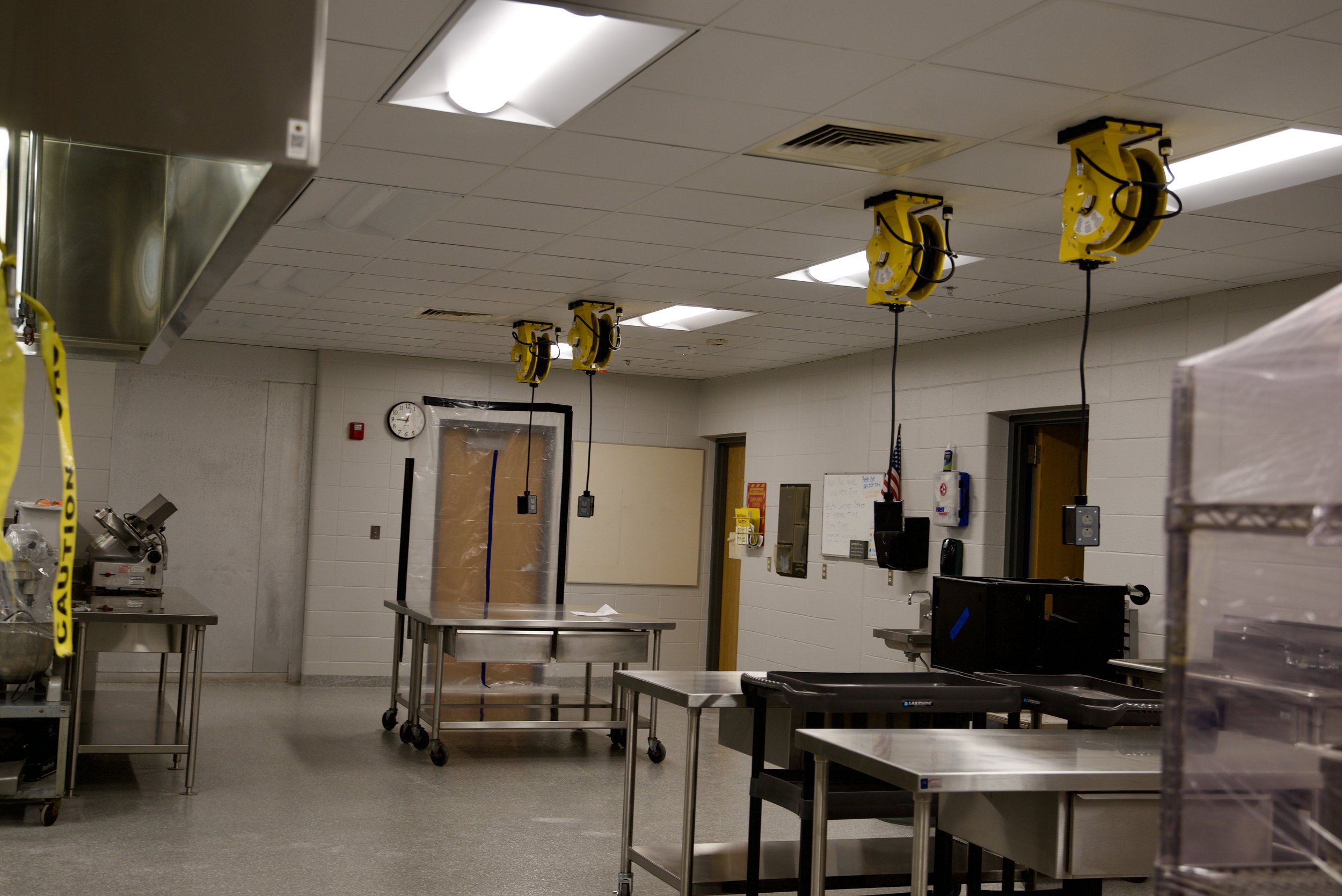

β€’ Electrical updates in Culinary foods lab

β€’ Additional epoxy flooring in kitchen dry storage area.

2025 Progress Photos

2026 Progress Photos

Completing the work we said.

On time.

Within budget.
